Large construction projects rarely begin on a blank canvas.
Existing infrastructure, aging utilities, occupied facilities, and complex site conditions can all create challenges long before the first foundation is poured. When these issues are discovered during construction, they can slow progress, disrupt operations, and introduce unexpected costs.
To address these challenges, owners often adopt a strategy that allows projects to begin earlier and move forward with greater certainty: enabling projects.

What is an enabling project?
An enabling project is a package of work completed ahead of the main building effort to prepare the project and resolve potential constraints.
This work may include demolition of existing structures, relocation of utilities, environmental remediation, or infrastructure improvements required before new construction can begin. In some cases, enabling work also establishes temporary access roads, staging areas, swing space, or utility systems needed to support the construction process.

A current example of this approach is underway at Louisiana State University, where our team is preparing the campus for the future Library and Learning Commons.

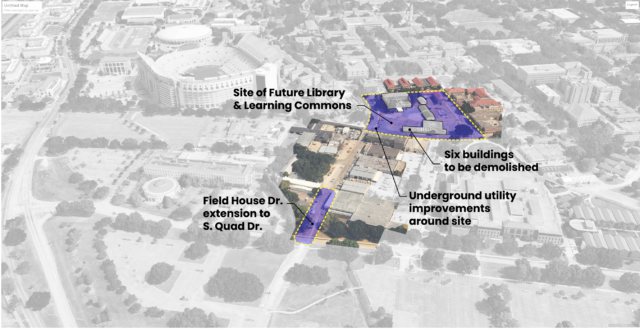

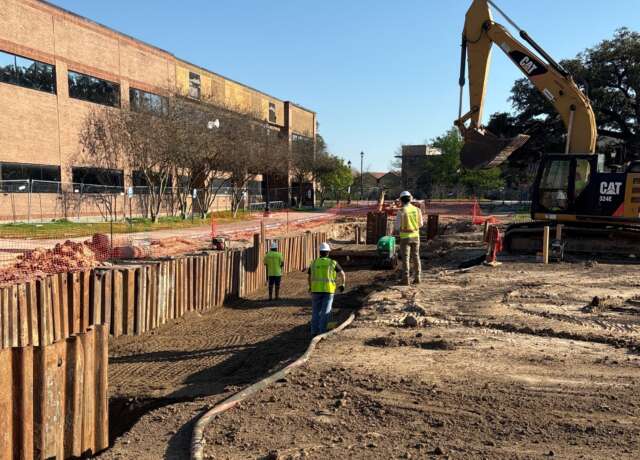

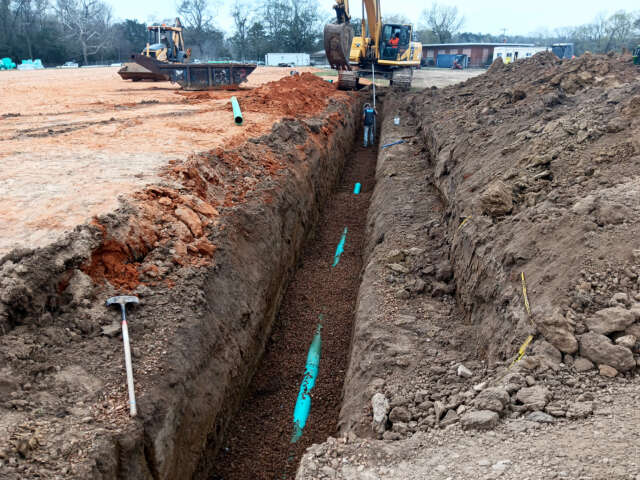

The enabling project includes extending Field House Drive to connect with South Quad Drive to improve campus circulation, installing new underground utilities to serve the future library site, and completing the abatement and demolition of six existing buildings.

These $11.4 million infrastructure improvements will prepare the site and surrounding campus systems so the new library facility can move forward efficiently and on time.
The role of Preconstruction planning
The most effective enabling strategies begin during preconstruction, when the project team studies site conditions, infrastructure, and operational considerations to determine how a project can move forward most efficiently.
This process often begins by working backward from the project’s required completion date. By understanding when a facility needs to open or when funding deadlines must be met, the team can map out the sequence of activities necessary to begin construction on time and maintain momentum throughout the project.

This planning process helps identify opportunities for enabling work that should occur earlier in the schedule. In some cases, that may include advancing demolition, relocating utilities, or completing site preparation before the full building design is finalized.
These scopes can often be delivered through early release packages, allowing critical work to begin while the remaining design continues to develop. In other situations, projects may be structured using a phased Guaranteed Maximum Price (GMP) approach. This allows the team to establish cost and schedule certainty for early phases of work while later portions of the project continue through design and refinement.
This strategy is currently being used on the Multipurpose Education Complex for Avoyelles Parish School Board, where our team is delivering the project through a phased CMAR process.

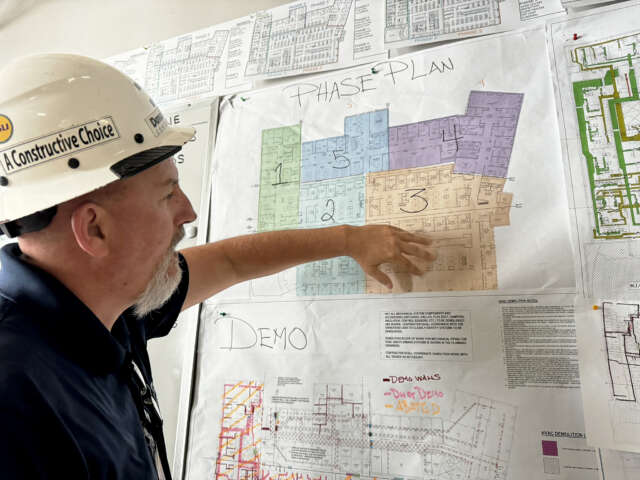

Because the project is funded through a state grant requiring funds to be spent within the year, the team implemented several phased GMP milestones with early release packages for demolition, civil work, building pad preparation, foundations, and structural steel.

By advancing these scopes strategically, the project team was able to maintain schedule momentum while the design continued to develop, ultimately delivering a final GMP that came in under the project’s $12 million budget.
Supporting projects within active facilities
Enabling strategies can also help organizations complete renovations within active facilities where maintaining operations is essential.

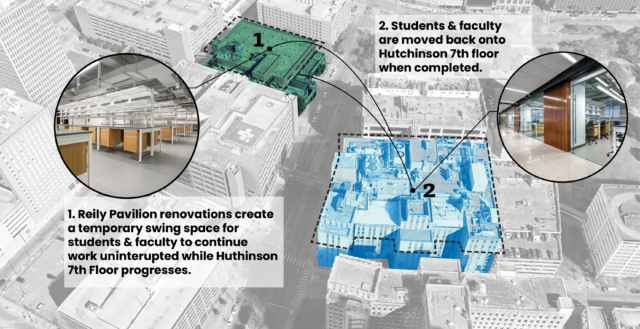

At Tulane University School of Medicine, the university planned renovations to the seventh floor of the Hutchinson Building. However, completing that work required temporarily relocating the students and faculty who occupied the space. To make the renovation possible, our team first renovated the fourth floor of the nearby Reily Pavilion to create a temporary swing space. Once that renovation was complete, students and faculty were relocated from the Hutchinson seventh floor into the newly prepared space.

With occupants safely relocated, the team was then able to proceed with renovations to the Hutchinson Building.
By creating this enabling phase early in the project, the university was able to maintain continuity for its academic programs while allowing construction to move forward efficiently.
Setting up projects for success
Construction projects frequently involve unknown site conditions, infrastructure constraints, or operational challenges that can introduce delays if they are discovered mid-project. Enabling projects help to address these issues early by allowing teams to investigate conditions, prepare the site, and establish logistics before the main construction effort begins.

Enabling projects are viewed as an important part of the broader preconstruction strategy. By identifying opportunities for early work and structuring projects through phased delivery methods, the team helps owners reduce uncertainty and move projects forward with greater confidence. When enabling work is planned thoughtfully, it does more than prepare the site. It creates a stronger starting point for the entire project.
Noteworthy Projects & Recent Completions


Lady of the Sea General Hospital
Our team recently completed the new replacement hospital for Lady of the Sea, who celebrated their official ribbon cutting in March. Located in Cut Off, LA, the existing hospital was devastated after Hurricane Ida, leaving the community without access to proper medical care. This significant CMAR project involved the construction of an 80,000-square-foot ground-up hospital that houses vital facilities such as the emergency department, inpatient unit, imaging services, cardiopulmonary, laboratories, pharmacy, a dining area, administration facilities, and a new power plant for reliable energy supply.

Tulane School of Medicine Hutchinson 5th Floor
The Tulane Hutchinson 5th Floor Renovation has been successfully completed as part of our continued work at Tulane University’s Downtown Campus. Following the completion of the Tulane Reily Pavilion 4th Floor renovation and in parallel with the Tulane Hutchinson 7th Floor Renovation, this project marked the third Tulane project delivered within just over 18 months. The renovation encompasses just under 6,000 square feet on the 5th Floor of the Hutchinson Building and focused primarily on laboratory and tissue culture spaces.

LSU Learning Commons
In collaboration with our JV Partner, Milton J. Womack, the Womack-Donahue team was selected to serve as the CMAR for this momentous project on LSU’s campus. The new nearly 200,000-square-foot state-of-the-art library will be centrally located on the campus, uniting the LSU community in ways and methods not possible in the current main library, serving as a bustling hub of classrooms, flexible event spaces, study spaces, collections, exhibit spaces, staff and partner spaces, and technologically-rich creative spaces. This $125 million project will undergo a lengthy preconstruction process with construction expected to begin in Q3 2026.

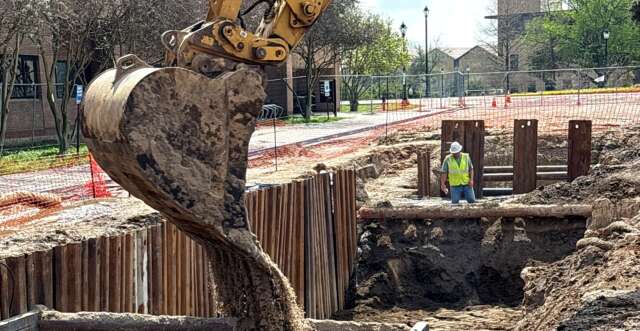

LSU Infrastructure Enabling Project
